Sometimes, the most remarkable changes can come about in the most innovative ways. In the heart of New York City, a major railway revitalization project has not only brought new life to an aging structure but has done so in a manner that demonstrates both creativity and efficiency. Let’s delve into this inspiring transformation journey along Park Avenue.

In a bustling city like New York, an important railway line, over 132 years old, stood as a testament to the passage of time. Known as the Park Avenue Viaduct, the structure was critical, accommodating around 750 Metro-North trains daily into the iconic Grand Central Station. However, the years had taken their toll, prompting a well-timed renovation.

The city’s Metropolitan Transport Authority (MTA) entrusted Halmar International with the ambitious project, which kicked off in October 2023 and is slated to be completed by summer 2027. What’s truly impressive is that Halmar is currently operating $93 million under budget and a remarkable 51 months ahead of schedule! Talk about efficiency!

As part of the first phase, Halmar introduced an impressive hydraulic gantry system. This piece of machinery was designed to remove the old concrete and steel elements and replace them with brand-new, pre-fabricated sections, each weighing a hefty 190,000 pounds. These new pieces arrived fully equipped with track fasteners, guardrails, and walkways, ready to be installed seamlessly.

According to Engineering News Record, the first phase involved 19 weekends of hard work. The crew successfully installed 8,240 feet of track between East 115th Street and East 123rd Street, transforming this vital section of the railways. It’s incredible to think that they accomplished this feat while keeping the rhythm of urban life undisturbed.

The gantry crane system brings a unique advantage to structural work, as it can operate directly above the project site. This innovation significantly reduces the need for additional space around the work area, something particularly crucial in a crowded city like New York.

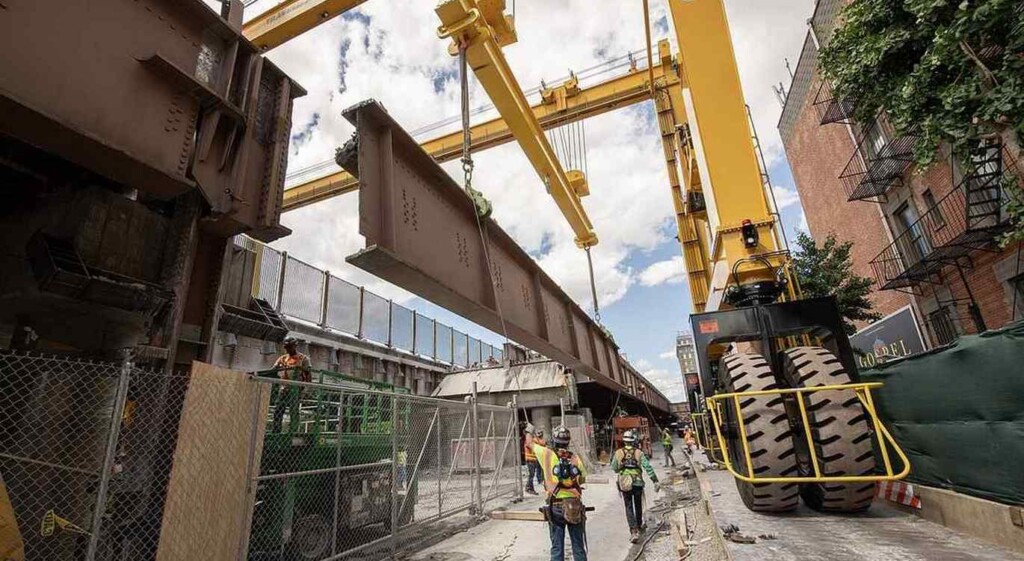

Construction workers using hydraulic gantry
Crews used a hydraulic gantry to quickly move new elements into position – credit, Metropolitan Transport Authority, CC 2.0. via Flickr

To manage this enormous undertaking, Halmar collaborated with MiJack, the manufacturer who provided the largest gantry they’ve ever produced, optimizing it to work effectively over the viaduct. This smart adaptation allowed Metro-North service to remain operational on two of the four tracks while the remaining two were being replaced.

The process was fascinating. Crews expertly utilized concrete saws to slice away sections of the old bridge, which the gantry could swiftly pick up and transport away. The new sections were then laid down like smooth planks, reinvigorating the railway with each installation.

Remarkably, the first segment was completed 21 months ahead of schedule. Amidst the bustling urban environment, with foot traffic and local businesses nearby, the project continued without missing a beat. The next phase commenced in March 2024, covering the stretch from East 127th Street to East 132nd Street.

The work is set to wrap up by next April, and the entire city is looking forward to enjoying this enhanced infrastructure.
